Home / News /

Technical Insights

Steel Structure Construction: Six Stages, from Design Basis to Handover

Technical Insights

Authored by:

SynJect Engineering Team
10/26/2026
· 14 min read

Steel structure construction is one continuous chain of six stages, and each stage hands physical evidence to the next. A frame that arrives with mismatched holes will absorb weeks of rework on site. The same happens with an unqualified welding procedure or a primer below specification. For that reason, experienced buyers judge steel structure construction by its controls rather than by its tonnage. This guide walks the chain in the order a project runs it. It states the codes, the measurable limits and the inspection points at each step.

1. Stage 1: Design Basis and Detailing

Every downstream defect traces back to a decision taken before fabrication started. Design basis fixes the structural system, the load cases and the execution class. Detailing then converts that basis into shop drawings, CNC data and an anchor bolt plan.

The four structural systems and where each fits

Steel buildings do not share one governing code path. The system type decides the analysis model, the connection family and the inspection regime.

SystemTypical rangeGoverning design standard
Portal frame (PEB)12–60 m clear span. Up to 80 m with haunched kneesEN 1993-1-1. EN 1993-1-3 for cold-formed secondary members. AISC 360 in US practice.
Multi-storey steel frame3–30 storeys. Braced or moment-resistingEN 1993-1-1 with EN 1998-1 for seismic. AISC 360 with AISC 341.
Space frame and grid shell40–200 m roof spansEN 1993-1-8 for node and joint resistance. AISC 360 Chapter K for hollow sections.
Concrete-filled steel tube with RC coreHigh-rise above 100 mEN 1994-1-1 for composite action. AISC 360 Chapter I.

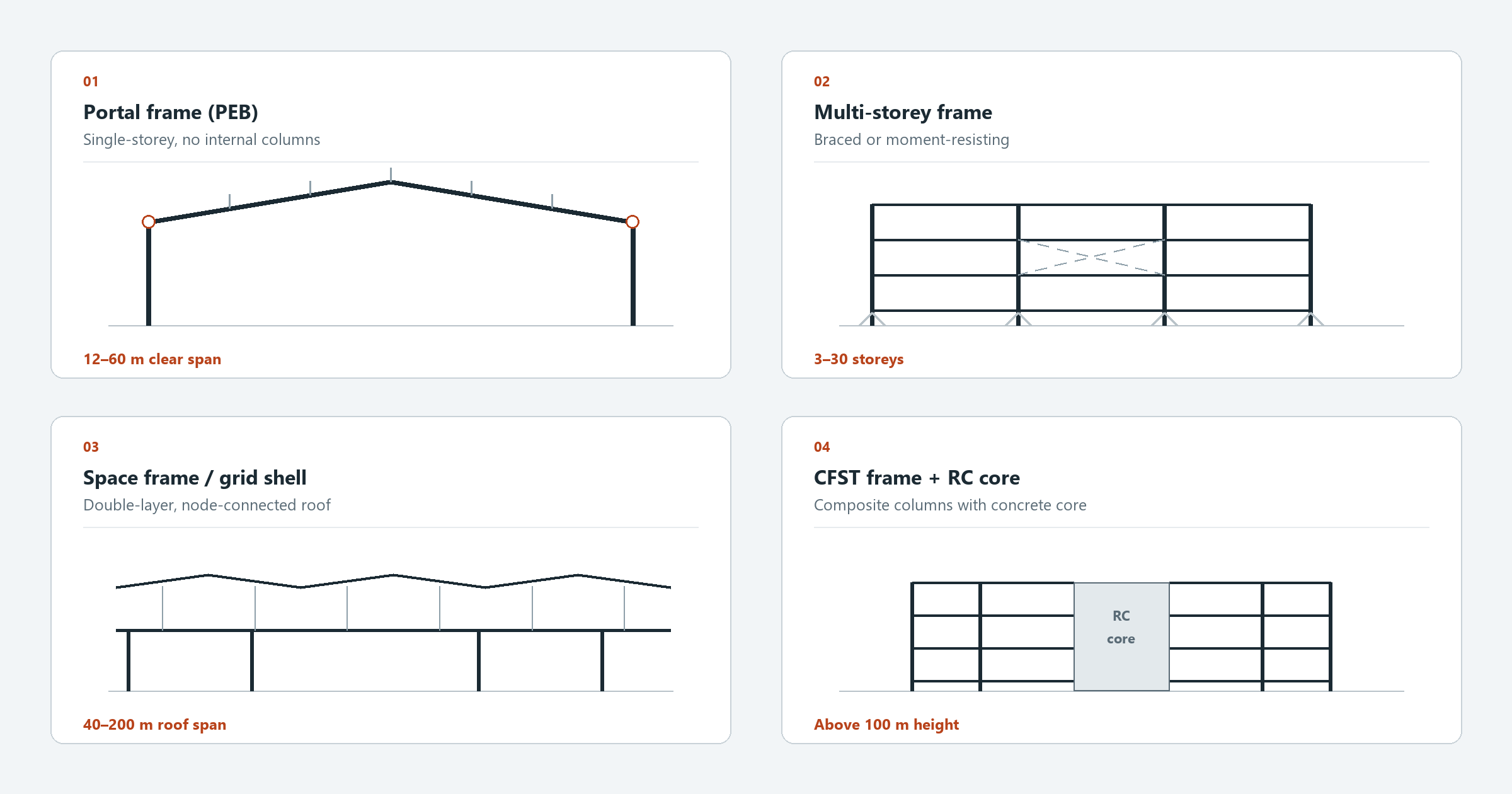

Four steel structural systems used in steel structure construction: portal frame, multi-storey frame, space frame and CFST core
Four systems, four code paths. The structural type fixes the analysis model, the connection family and the inspection regime. Figure: SynJect engineering.

Design basis: AISC 360 or Eurocode 3

The project jurisdiction decides which family applies. So does the client specification and the EPC house standard. Loads follow ASCE 7-22 in US practice. EN 1991 governs in Europe and most of the Middle East, Africa and Central Asia. Seismic design follows AISC 341 or EN 1998-1. Execution class follows EN 1090-2. EXC2 covers most buildings, while EXC3 applies to bridges, high-seismicity frames and heavily cycled structures.

Mixing code families inside one package causes rework. A connection detailed to EN 1993-1-8 will not match a bolt schedule written to the RCSC Specification. The mismatch surfaces only at connection approval, which is late. We therefore lock one primary code family per package. We also record every deviation in the design basis document.

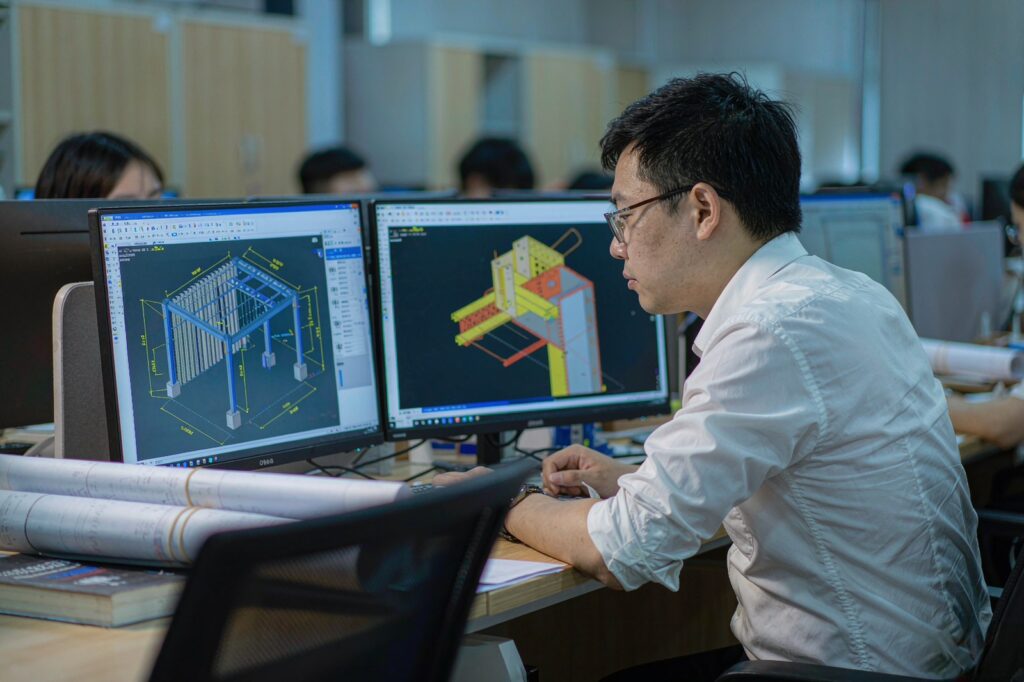

Detailing engineer reviewing a steel structure BIM model and a bolted connection node before fabrication
In short, model coordination to LOD 400 resolves node clashes before the first plate is cut. Figure: SynJect engineering.

Detailing, BIM and the anchor bolt plan

Therefore, detailing is a second design pass, not a drafting task. Its purpose is to make the frame fabricable, shippable, erectable and economical at the same time. Model coordination follows ISO 19650 information-management principles. We work the model to LOD 400, so bolts, stiffeners and weld access holes appear as real geometry rather than symbols.

Three checks at this stage prevent most site delays. First, clash resolution with civil, mechanical, electrical and fire-protection services. Second, weld access and bolt wrench clearance, verified in 3D rather than assumed on a 2D detail. Third, an anchor bolt setting plan issued before the foundation pour, with template frames and a stated positional tolerance of ±3 mm.

2. Stage 2: Fabrication, Coating and Logistics

In short, fabrication converts design intent into tolerance-controlled hardware. Material traceability, hole accuracy and trial assembly decide whether the frame closes on site.

Certificate and grade checks

Steel arrives with EN 10204 3.1 mill certificates. We re-check grade, heat number and impact properties against the drawing register. Common grades are S275 and S355J2 to EN 10025-2 for European and export markets. ASTM A992 or A572 Grade 50 covers US practice. Submerged-arc welded heavy sections often use S355J2+N or A913 Grade 65. For weldability, we normally hold carbon equivalent at or below 0.45. We also specify Charpy impact tests at 27 J at −20 °C for J2 material.

Fabrication limits that matter on site

ParameterLimitReference
Member length (shop)±2 mmEN 1090-2 Annex D.
Straightness of welded columnsL/750EN 1090-2 Annex D.
Hole position within a group±1 mmShop drawing and AISC 303 practice.
Displacement between hole groups3 mm maximumAISC 303.
Base plate flatness1 mm per 300 mmEN 1090-2.
Mill certificateEN 10204 3.1 with full traceabilityEN 10204.

CNC drilling rather than punching keeps hole quality predictable above 6 mm plate. Oversize or slotted holes appear only where the designer intends them. This rule matters, because an oversized hole silently converts a bearing connection into a slip-critical problem.

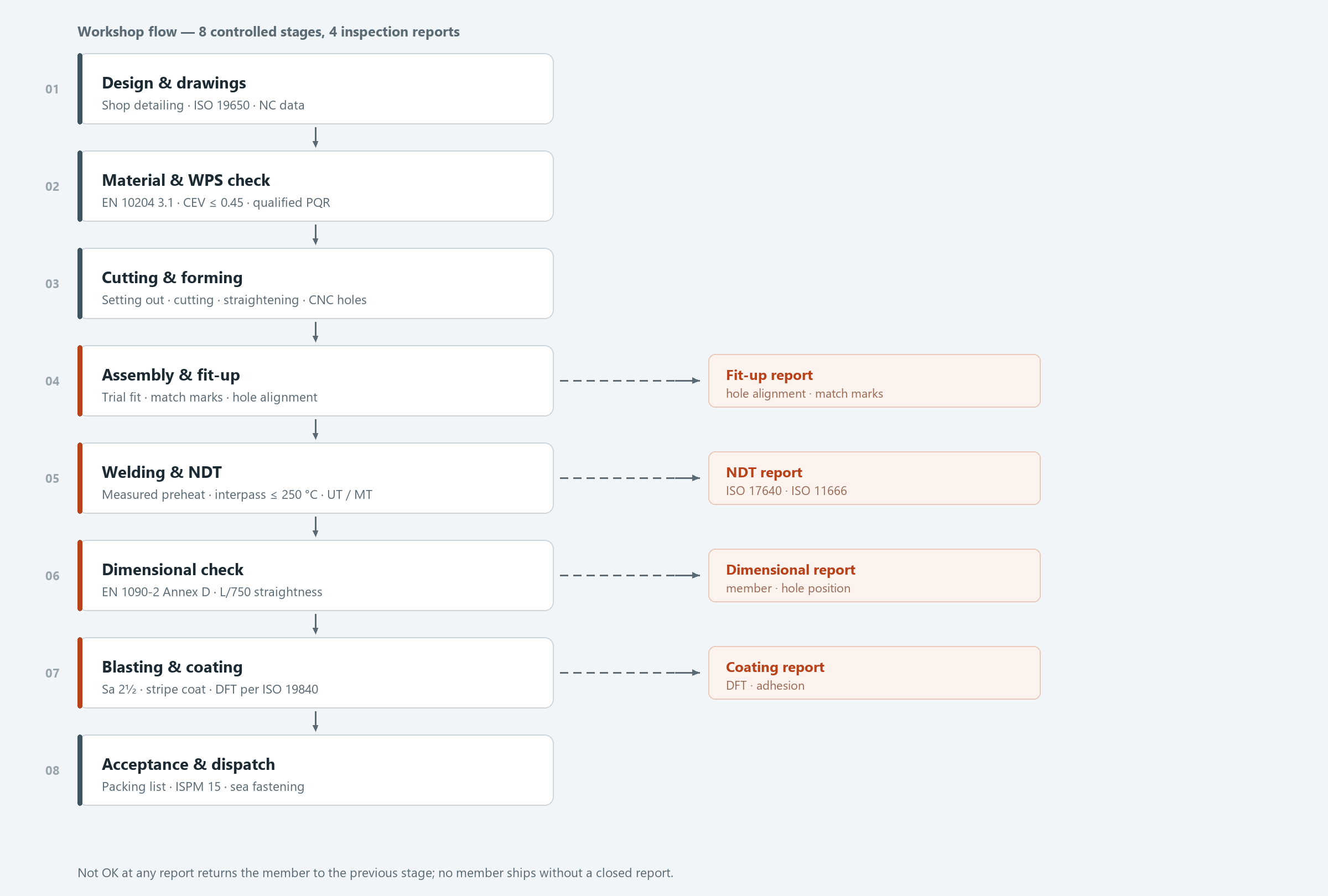

Structural steel fabrication process flow for steel structure construction, from shop drawings to dispatch
Eight controlled stages, four inspection reports. A member returns to the previous stage if any report is not closed. Figure: SynJect engineering.

Trial assembly and transport engineering

Complex nodes, skewed portals and stadium roof segments go through trial assembly in the shop. We pre-assemble bolted interfaces to confirm hole alignment, then mark match-numbers on every mating face. For example, we normally trial-fit a 60 m clear-span portal with tapered haunches in three sections. The knee joint is then proven before shipment.

Oversize members need a route survey before they need a crane. Where road transport is impossible, break-bulk design or water transport keeps the member within shippable limits. Packaging follows ISPM 15 for timber. Sea fastening follows the IMO CSS Code. Finally, each bundle carries a packing list keyed to the erection drawing, so the site team can stage steel by bay rather than by consignment.

3. Stage 3: Erection Sequencing by Structural Type

Erection is the point where steel structure construction becomes irreversible. In practice, sequence decisions taken here rarely reverse later. Sequence, temporary stability and survey frequency drive both safety and final geometry.

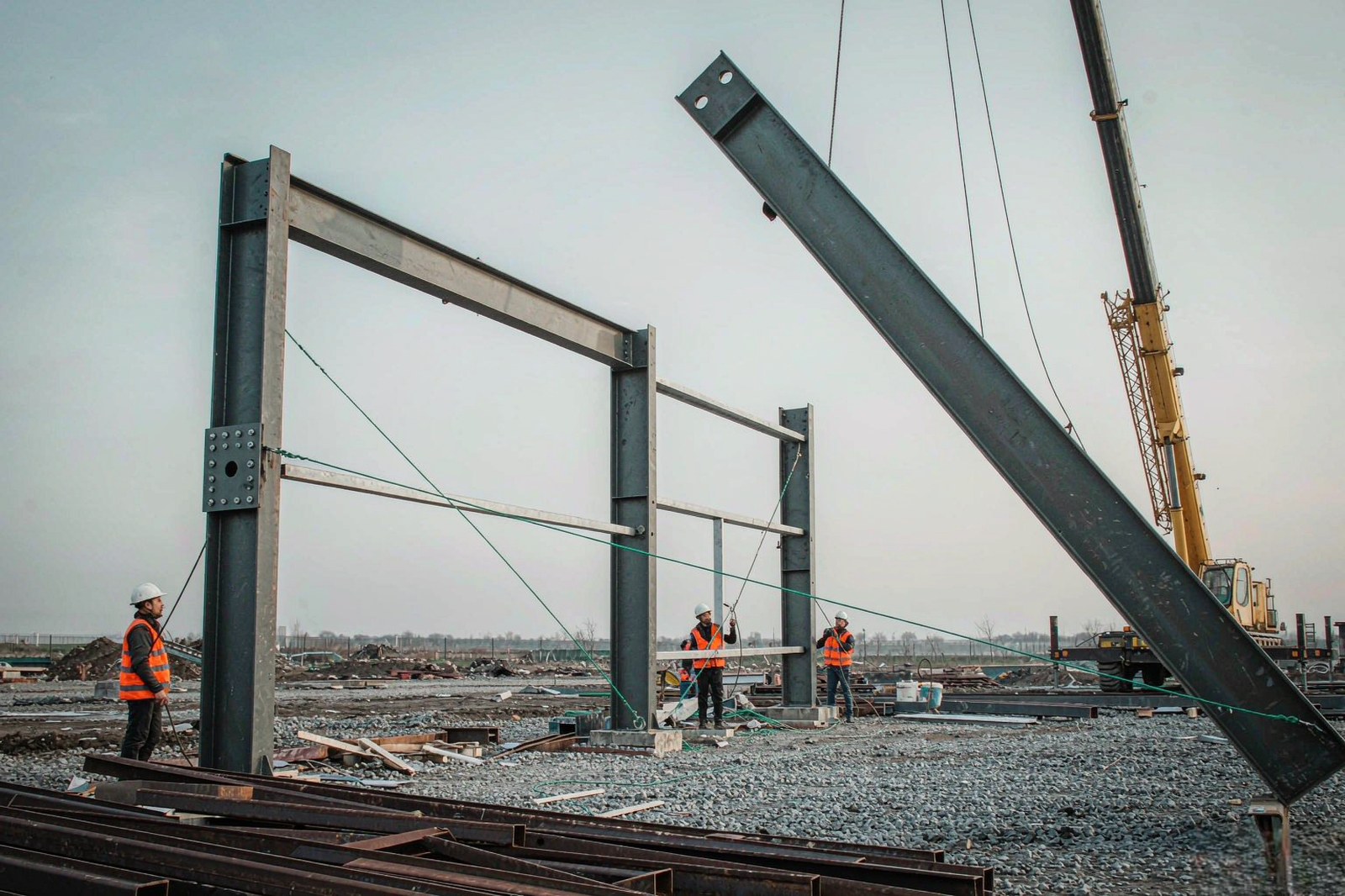

Steel structure construction site with a crawler crane lifting a welded portal frame rafter into position
Braced bay first, then controlled bay-by-bay completion. In addition, guys stay in place until the permanent bracing set is inspected.

Single-storey portal frames

We erect the braced bay first, then complete bays in a controlled order. We plumb each frame and guy it temporarily before final bolt tightening. Purlins and fly braces follow immediately, because an unbraced portal is a mechanism rather than a structure. Moreover, we release temporary guys only after the permanent bracing set is complete and inspected.

Multi-storey frames

Multi-storey work usually leads the concrete core by three floors. As a result, the decking and concrete chase follow the steel. The survey team re-establishes column line after every third level. It uses an internal control method and transfers benchmarks through floor openings instead of relying on external sight lines. As a result, error does not accumulate with height.

Long-span roofs: integral lifting and cumulative sliding

We assemble large roofs at grade and then move them. Working at height costs more and inspects worse. Two methods dominate.

  • Integral lifting. Hydraulic strand jacks raise a completed roof from temporary support towers. Typical rate is 2–6 m per hour, with lifting points synchronised to a few millimetres. Engineers monitor load per jack and stop the lift if any point leaves the set envelope.
  • Cumulative sliding. We assemble the roof in 10–20 m blocks behind the permanent line. Hydraulic jacks then push it forward on rails, block against block, until the full span closes.

Temporary towers, pre-camber and staged de-propping decide the final stress state. We usually set camber to the calculated dead-load deflection. We also simulate the release sequence before execution. Indeed, de-propping in the wrong order can double the moment in a girder designed for a single load path. We therefore release in stages: typically 25, 50, 75 and 100 percent of the support set. Deflection readings are taken at each stage.

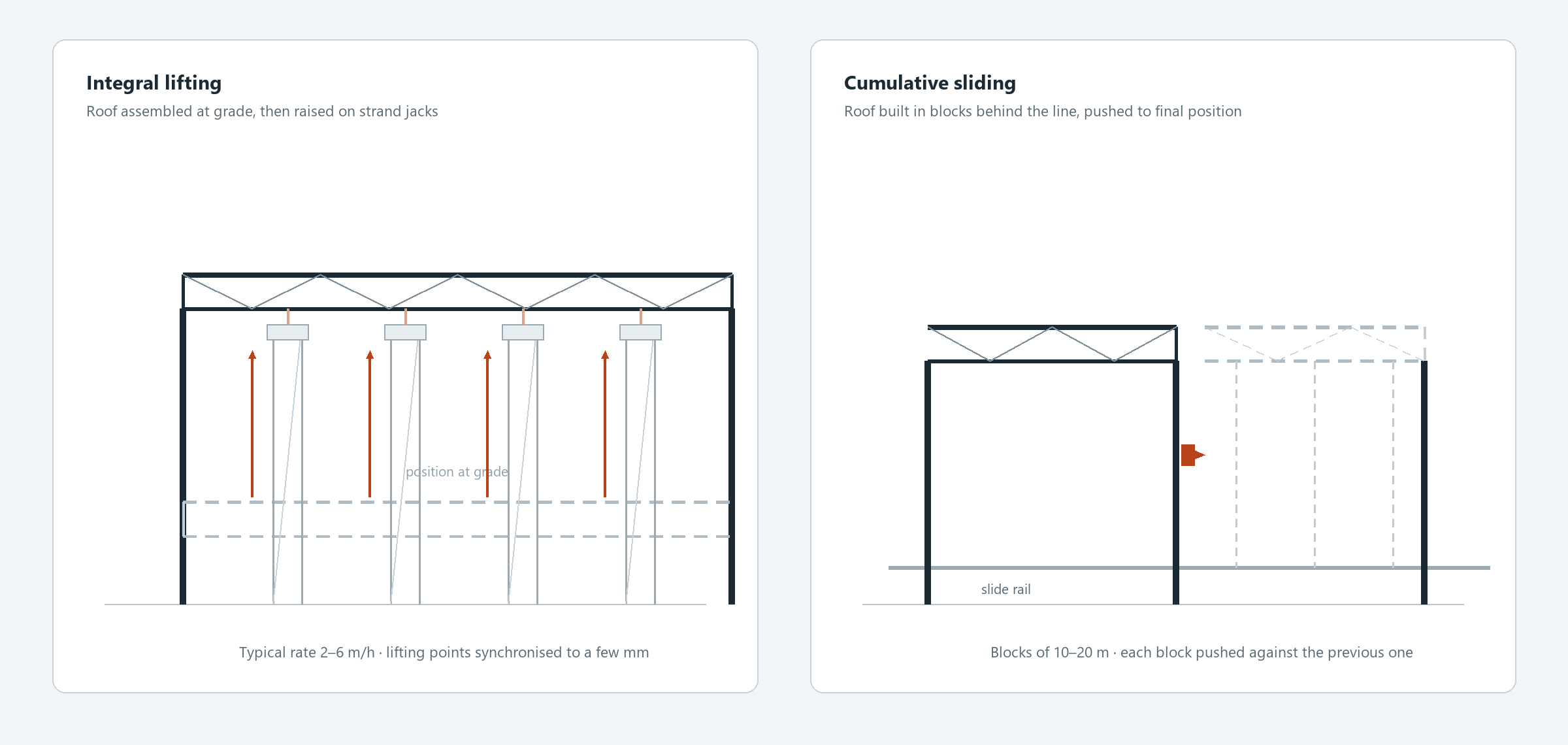

Long-span roof erection by integral lifting and cumulative sliding in steel structure construction
Two long-span methods. In practice, crews assemble the roof at grade and raise it on strand jacks. By comparison, hydraulic jacks push roof blocks along rails against the completed line. Figure: SynJect engineering.

Space frames

We assemble space frames outward from a fixed datum. Every node is set by three-dimensional coordinate rather than by tape. Bolted ball nodes and sleeve joints need a specified tightening torque, applied in the same rotational direction. That habit avoids imposing twist into the node.

4. Stage 4: Connection Integrity

Connections carry the frame, and they fail quietly. Accordingly, welding and high-strength bolting each need their own qualification trail.

Procedure, preheat and weld inspection

Every production weld runs on a qualified WPS backed by a procedure qualification record. Qualification follows ISO 15614-1 in European practice. AWS D1.1 Clause 4 governs in US practice. Welders hold ISO 9606-1 or AWS D1.1 Clause 6 certification for the position and process they use.

ControlTypical specification
WPS and PQRISO 15614-1 or AWS D1.1 Clause 4.
Welder qualificationISO 9606-1 or AWS D1.1 Clause 6.
Weld quality levelEN ISO 5817 level C at EXC2. Level B at EXC3.
Preheat, S355 at 20–40 mm80–150 °C, per EN 1090-2 Table 16 or AWS D1.1 Table 3.2.
Interpass temperatureCapped at 250 °C to protect toughness.
Heat input0.8–2.5 kJ/mm for FCAW and GMAW. Up to 4.0 kJ/mm for SAW.
Ultrasonic testingISO 17640, acceptance to ISO 11666. Scheduled at least 24 h after cooling.
NDT extentAbout 5 percent at EXC2. 10 percent at EXC3. 100 percent on critical tension welds.

Distortion control is a sequencing problem. We balance welding about the neutral axis, keep passes symmetric and avoid completing one side of a built-up member before the other. We measure preheat on the steel with a contact thermometer rather than infer it from ambient temperature. A cold plate pulls heat out of the arc faster than the procedure assumes.

High-strength bolting

Bolted connections fall into three families. Confusing them is a common and expensive error.

Joint typeMethodWhere it applies
Snug-tight bearingFirm contact, no specified pretensionSecondary members, purlins, non-slip joints.
PretensionedTurn-of-nut, calibrated wrench, direct tension indicator or tension-control boltMoment connections and seismic framing.
Slip-criticalPretensioned with faying surface slip factor of at least 0.50Oversize or slotted holes. Fatigue-sensitive joints.

Bolt assemblies are ASTM F3125 Grade A325 or A490 in US practice. EN 14399-3 HR or EN 14399-4 HV system 10.9 covers European practice. Target preload is 0.70 of the bolt ultimate strength times the tensile stress area. We blast clean faying surfaces to Sa 2½ to ISO 8501-1 and leave them unpainted inside the joint. Paint destroys the friction coefficient.

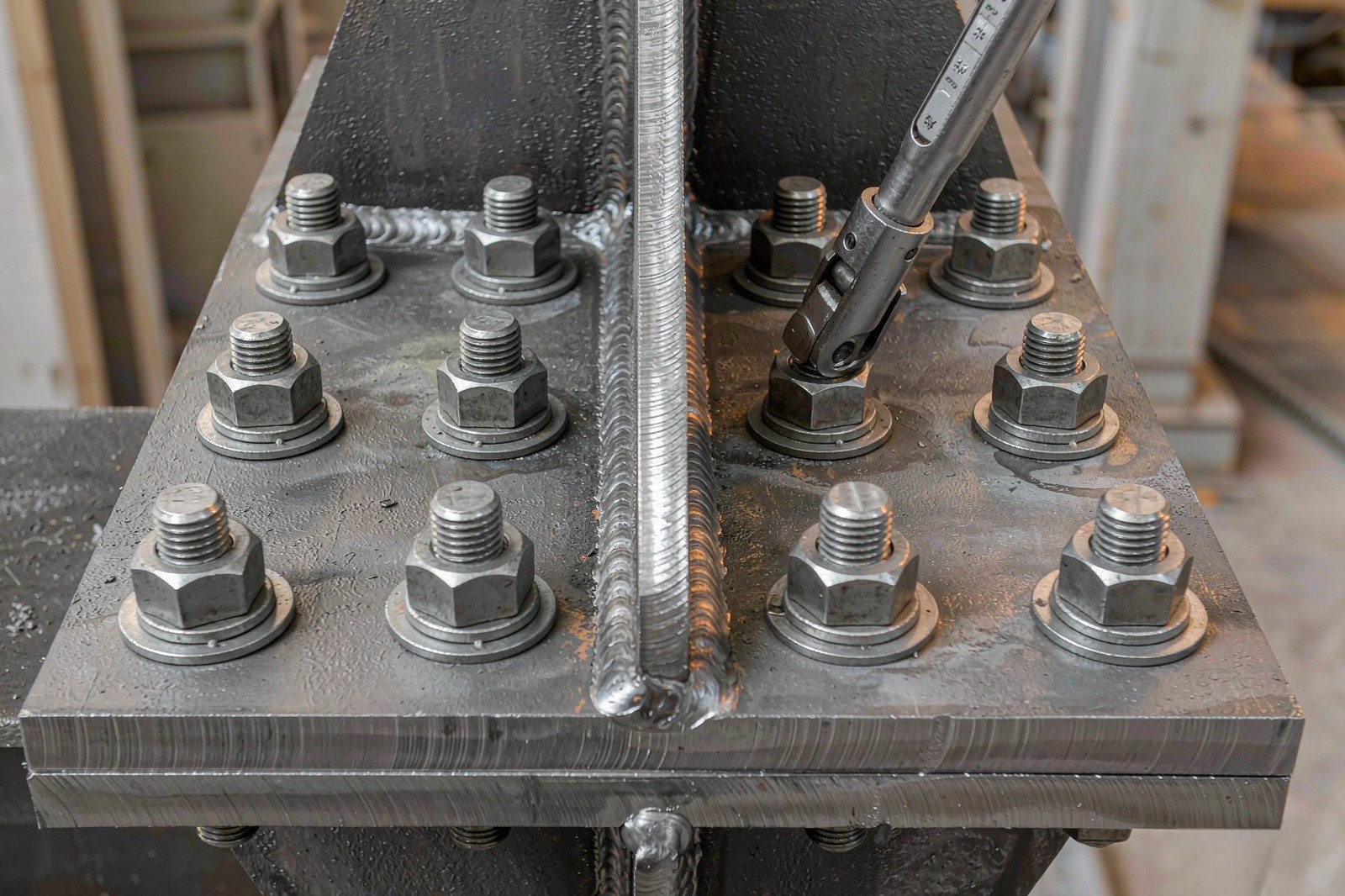

High-strength structural bolts tightened with a calibrated torque wrench on a spliced steel plate
We calibrate each wrench batch daily on a Skidmore-Wilhelm device and log it against the bolt lot.

Tightening runs in two stages. A first pass brings the joint into contact. Final tightening then proceeds from the stiffest part of the connection outward. Moreover, high-strength bolts never serve as temporary erection bolts. Repeated use destroys the coating and the torque-tension relationship. We calibrate each wrench batch daily on a Skidmore-Wilhelm device and log the result against the bolt lot.

5. Stage 5: Decking, Corrosion Protection and Fire Protection

The structure does not finish with the last bolt. In practice, the envelope decides whether the frame survives its service life. Steel structure construction ends only when the envelope resists water, corrosion and fire as designed.

Metal decking and shear studs

Our crews set composite deck with correct end bearings and close the side laps before placing any concrete. We weld shear studs through the deck to EN ISO 14555 or AWS D1.1 Clause 9. The first studs of each shift are bent 30 degrees for a bend test. We also check deck loading during construction against the SDI or manufacturer span tables. A concrete buggy can overload an unpropped deck long before the slab reaches design strength.

Corrosion protection

Coating selection starts with the corrosivity category of the site, not with a standard thickness. ISO 12944-2 defines categories from C2 to C5, and ISO 12944-5 links each to a system.

CategoryEnvironmentTypical total dry film thickness
C3Urban and industrial, moderate SO₂160–200 µm.
C4Coastal, industrial, high humidity240–280 µm.
C5Severe coastal, salt-laden or chemical320–400 µm.
Hot-dip galvanizingExternal, maintenance-free exposure85 µm minimum average to EN ISO 1461 above 6 mm thickness.

Surface preparation is Sa 2½ to ISO 8501-1 with a medium angular profile. Application stops when relative humidity exceeds 85 percent. It also stops when steel temperature sits within 3 °C of the dew point, since condensation under a fresh coat guarantees premature failure. The applicator stripe-coats welds, bolt heads and edges. We then measure dry film thickness to ISO 19840 using the 80 percent rule.

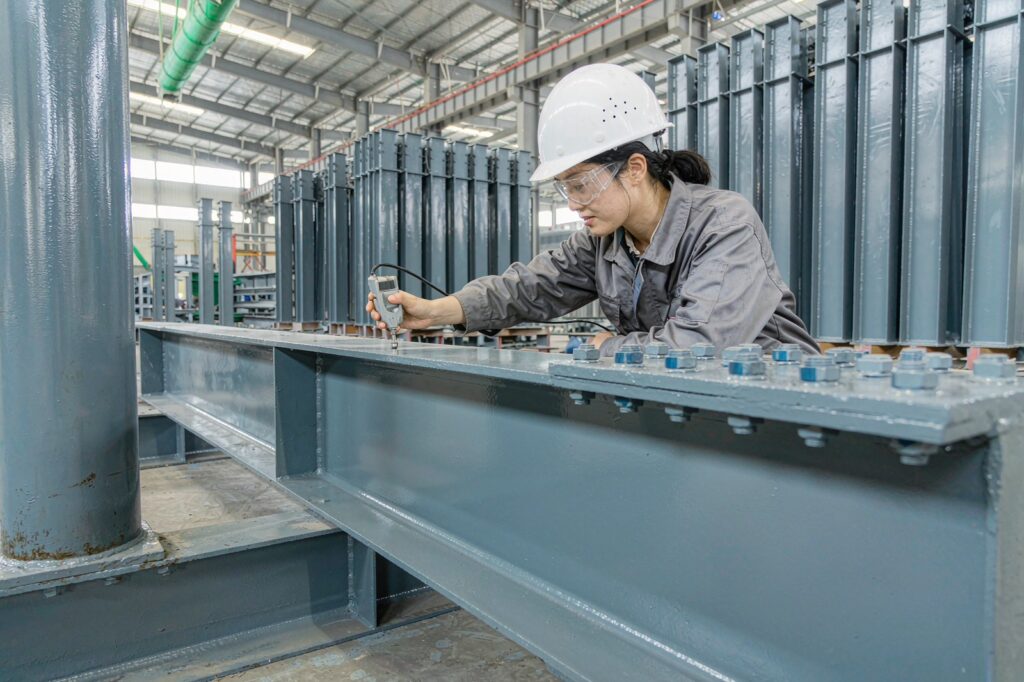

Coating inspector measuring dry film thickness on a primed steel column in a fabrication shop
We measure dry film thickness to ISO 19840 using the 80 percent rule, member by member.

Fire protection

We specify intumescent coatings by fire resistance period and section factor. Each system is validated by furnace test to EN 13381-8. Boards and sprays follow EN 13381-4 or the national approval. A member rated R60 carries a much thinner film at a low section factor than at a high one. The applicator therefore works from a schedule keyed to each member size, not from an average thickness.

6. Stage 6: Verification, Survey, Safety and Handover

Above all, verification is not a final inspection. It is a set of witness points distributed through the chain, and each one produces a record the next stage depends on.

Testing and witness sampling

We sample steel, welding consumables, high-strength bolts, welds and fire-protective coatings by batch against the project inspection and test plan. Tensile testing follows EN ISO 6892-1 and impact testing EN ISO 148-1. The client or a third-party inspector witnesses bolt sampling. For example, a typical 2,000 tonne package generates several hundred records before shipment, and we index each one to a member mark.

Survey control

Survey closes the loop between design geometry and built geometry. The team re-checks the primary benchmark against a national grid before erection starts. High-rise work uses an internal control method with forced-centring instruments through floor openings. Space frames and curved beams are set by three-dimensional coordinate from a total station. We hold column plumbness to 1:500 under AISC 303 and record elevation at each tier instead of assuming it.

Erection engineering and safety

We design safety on a steel frame rather than supervise it. In US jurisdictions, OSHA 1926 Subpart R requires an erection plan and a pre-erection conference before work begins. Fall protection is mandatory above 1.8 m. It usually takes the form of perimeter cable, personal lifelines and controlled decking zones.

We calculate every critical condition before it occurs:

  • Single-crane and tandem lift plans, with rigging angles and centre-of-gravity checks.
  • Temporary support and guy forces, including wind on the partially erected frame.
  • Crane track and outrigger loads on suspended slabs or backfilled ground.
  • Staged de-propping and its effect on member forces.

In addition, hot work needs a fire watch, spark containment and a permit system, because welding slag reaches the floor below through open deck gaps.

Handover documentation

A complete handover pack contains as-built drawings, mill certificates, WPS and welder qualifications, NDT reports, bolt calibration logs, coating thickness records, survey reports and the operation and maintenance manual. By comparison, a package that arrives without these records costs the client time in commissioning and in any later insurance claim.

7. Where Steel Structure Construction Fails

Most site problems repeat across projects and countries. They cluster into a short list.

SymptomRoot causeControl
Columns will not fit anchor boltsAnchor plan issued after the foundation pourTemplate frames and a ±3 mm setting plan released early.
Holes misalign at sitePunched holes, no trial assembly, cumulative shop errorCNC drilling, trial fit of bolted interfaces, match-marking.
Weld cracking within 48 hoursNo preheat on thick plate, high restraint, hydrogenQualified WPS, measured preheat, 24 h hold before NDT.
Bolts lose tension in serviceReused bolts or uncalibrated wrenchSingle-use assemblies, daily calibration, lot traceability.
Coating blisters in year twoApplication near dew point, thin stripe coatsClimate logging, stripe coating, DFT and adhesion testing.
Roof deflects beyond predictionDe-propping out of sequence, camber ignoredStaged release simulation, deflection readings per stage.

8. How SynJect Runs the Chain

SynJect delivers steel structure construction as one controlled package. Design basis, BIM detailing, fabrication, coating, logistics and site supervision sit under a single quality system. Our works hold AISC certification and EN 1090-2 execution to EXC2 and EXC3 with CE marking. We also hold ISO 9001, ISO 45001 and ISO 14001 management certification. Design follows AISC 360 or EN 1993, welding follows AWS D1.1 or ISO 9606, and coating follows ISO 12944 with Sa 2½ preparation.

The practical difference appears at the interfaces, which is where most projects lose time. One team owns the anchor bolt plan, the shop drawing, the trial assembly and the erection sequence. Therefore nobody can blame the previous supplier for a hole that does not line up.

For a cost and lead-time baseline on a typical portal frame warehouse, read our PEB steel warehouse cost breakdown for the UAE. For project-specific sequencing, send drawings to our engineering team through SynJect steel structure solutions and we will return a fabrication and erection plan.

Frequently Asked Questions

How long does steel structure construction take?

Fabrication for a 2,000 m² warehouse usually runs 6–10 weeks after drawing approval. Erection of the primary frame then takes 2–4 weeks, depending on bay count and crane availability. Large-span or multi-storey projects extend both phases. However, the critical path usually sits in detailing approval rather than in the shop.

Which standard should an export project follow?

Follow the standard named in the contract and the local building authority. EN 1090-2 and EN 1993 suit Europe, the Middle East, Africa and Central Asia. AISC 360 and AISC 303 suit US-linked specifications. Steel structure construction that mixes both families without a written deviation list creates approval delays at the connection stage.

What tolerance is realistic for column plumbness?

AISC 303 sets 1:500 for column plumbness, and EN 1090-2 works to comparable essential tolerances. A 12 m column therefore sits within about 24 mm of true vertical. Tighter limits are achievable, but we must agree them before fabrication. They change the survey method and the temporary restraint plan.

Can high-strength bolts replace site welding entirely?

In most building frames, yes. A fully bolted frame with EN 14399-3 or F3125 assemblies removes hot work from the site. It also cuts weather risk and speeds erection. Welding remains necessary for moment connections in seismic framing, for built-up sections and for repairs.

How is welding quality verified on an export order?

Verification runs through documents and physical tests. The shop issues WPS and PQR records, welder certificates and NDT reports to ISO 17640 or ISO 17636. A third-party inspector then witnesses sampling and reviews heat numbers against mill certificates. That inspector signs the release before packing.

Standards referenced. Design: EN 1993, EN 1991, EN 1994, EN 1998, AISC 360, AISC 303, AISC 341, ASCE 7-22. Execution and welding: EN 1090-2, EN ISO 5817, EN ISO 9606-1, ISO 15614-1, EN ISO 14555, AWS D1.1. Materials and bolting: EN 10025-2, EN 10204, ASTM F3125, RCSC Specification, EN 14399. Protection: ISO 12944, ISO 8501-1, ISO 19840, EN ISO 1461, EN 13381-4 and EN 13381-8. Safety: OSHA 1926 Subpart R.
